This is the 183rd monthly Environmental Monitoring and
Audit (EM&A) report for the Project “Construction of Lamma Power
Station Extension” prepared by the Environmental Team (ET). This report presents the results of impact
monitoring on air
quality and noise for the said project in July 2025.
The reclamation
and submarine pipeline works were completed with the first gas-fired combined
cycle unit (viz. Unit L9) commissioned in October 2006, working currently on
base load operation. To cope with the
scheduled retirement of the existing units at Lamma Power Station, the second
gas-fired combined cycle unit (viz. Unit L10) L10 was commissioned for reliable
operation in February 2020.
In September 2016,
the Government approved HK Electric to construct the third combined cycle
gas-fired generating unit (Unit L11) to implement the 2020 Fuel Mix Target. L11 was commissioned for reliable operation
effective in May 2022.
With the
Government’s approval to build the fourth combined cycle gas-fired
generating unit (L12) in July 2018, the associated construction work commenced
in April 2019. L12 was commissioned for
reliable operation effective on 31/3/2024.
The operational EM&A work for L9, L10, L11 and L12 is recorded in
the separate monthly EM&A report for the Project “Operation of Lamma
Power Station Extension”.
With the Government’s approval to build the fifth combined cycle gas-fired generating unit (L13) in November 2023, the associated construction work commenced in end January 2024.
Air and noise monitoring were performed. The results were checked against the established Action/Limit (AL)
levels. An on-site audit was conducted once per week.
The implementation status of the
environmental mitigation measures, Event/Action Plan and environmental complaint
handling procedures were also checked.
Construction
Activities Undertaken
Construction activities
for Lamma Extension during the reporting month are tabulated as follows:
Item |
Construction
Activities |
Unit L13 Civil and Building Works |
Civil advance work |
Environmental
Monitoring Works
All monitoring work at
designated stations was performed as scheduled satisfactorily.
Air Quality
No exceedance of Action/Limit levels on 1-hour TSP and 24-hour TSP for air quality was recorded in the month.
Noise
No exceedance of Action and Limit levels for noise arising from the construction of Lamma Extension was recorded in the month.
Site Environmental
Audit
Independent
Environmental Checker (IEC) conducted a site inspection on 24/7/2025. The site conditions were generally
satisfactory.
Site
audits were carried out on a weekly basis to monitor environmental issues on
the construction site. The site
conditions were generally satisfactory.
Environmental
Licensing and Permitting
Description |
Permit No. |
Valid Period |
Issued To |
Date of Issuance |
|
From |
To |
||||
Varied Environmental
Permit |
EP-071/2000/D |
28/09/20 |
- |
HK
Electric |
28/09/20 |
Construction Noise Permit |
GW-RS0498-25 |
19/05/25 |
18/11/25 |
Contractor |
14/05/25 |
WPCO Discharge Licence |
WT100046647-2025 |
18/07/25 |
31/07/30 |
Contractor |
18/07/25 |
Waste Disposal Billing
Account |
Account No.: 7054247 |
03/04/25 |
- |
Contractor |
03/04/25 |
Implementation
Status of Environmental Mitigation Measures
Environmental
mitigation measures for the construction activities
as recommended
in the EM&A manual were implemented in the reporting month.
Environmental
Complaints
No complaint in relation to the environmental impact of the construction activities
was received in the reporting month.
Future
Key Issues
The future key issues to be
considered in the coming month are as follows:
Unit L13 Civil and
Building Works
- to
continue monitoring the noise level during construction and to ensure
compliance with the CNP’s already obtained;
- to
monitor and review the sufficiency of the dust suppression measures provided
and increase the resources accordingly if necessary;
- to treat
wastewater in sedimentation tank for re-use on construction activities and to
ensure compliance with the WPCO discharge licence already obtained.
Concluding
Remarks
The environmental performance
of the project was generally satisfactory.
The
Environmental Team (hereinafter called the “ET”)
was formed within the
Hongkong Electric Co. Ltd (HEC) to undertake Environmental
Monitoring and Audit for “Construction of Lamma Power Station Extension”
(hereinafter called the “Project”). Under the requirements of Section 6 of Environmental Permit EP-071/2000/D, an EM&A programme for impact environmental monitoring set
out in the EM&A Manual (Construction
Phase) is required to be implemented. In accordance with the EM&A Manual,
environmental monitoring of
air quality, noise and
water quality and regular
environmental audits are required for the Project. With the completion of reclamation and submarine pipeline works,
no further marine water quality monitoring would be required.
The Project
involves the construction of a gas-fired power station employing combined
cycled gas turbine technology, forming an extension to the existing Lamma Power
Station. The key elements of the Project
including the construction activities associated with the transmission system
and submarine gas pipeline are outlined as follows.
·
dredging
and reclamation to form approximately 22 hectares of usable area;
·
construction
of six 300MW class gas-fired combined cycle units;
·
construction
of a gas receiving station;
·
construction
of a transmission system linking the Lamma Extension to load centres on Hong
Kong Island;
·
laying
of a gas pipeline for the supply of natural gas to the new power station
This report summarizes
the environmental monitoring and audit work for the Project for the month
of July 2025.
An
Environmental Management Committee (EMC) has been set up in HEC to oversee the
Project. The management structure
includes the following:
·
Environmental
Protection Department (The Authority);
·
Environmental
Manager (The Chairman of the Environmental Management Committee);
·
Engineer;
·
Independent
Environmental Checker (IEC);
·
Environmental
Team (ET);
·
Contractor.
The project organisation chart for the construction EM&A programme is
shown in Appendix A.
1.3
Construction
Works undertaken during the Reporting Month
Construction activities for Unit L13 civil and building works were
civil advance work. Layout plan for construction
site is shown in Figure 1.1.
The main construction activities carried
out during the reporting month and the corresponding environmental mitigation
measures are summarized in Table 1.1.
The implementation of major mitigation measures in the month is provided
in Appendix I.
Table
1.1 Construction Activities and Their
Corresponding Environmental Mitigation Measures
Item |
Construction Activities |
Environmental Mitigation Measures |
Unit L13 Civil and Building Works
|
||
1 |
Civil Advance Work |
Wastewater
-
All wastewater will be pumped to the sedimentation ponds for
desilting process. After that, wastewater will be re-used for construction
activities or pumped for storage. -
All wastewater will be treated before discharge to fulfill the
requirement of wastewater discharge licence. Noise -
General
noise mitigation measure employed at all work sites throughout the
construction phase. -
Following all
requirement of Construction Noise Permit issued by EPD. -
Generators operate with
door closed. Waste
Management -
Waste
Management Plan submitted and implemented. -
Construction
will be store in the proposed storage area for recycled or disposal. Air -
Dust
suppression in the main haul road. -
Using
ULSD for PMEs. -
Cover
dusty stockpile with tarpaulin and water spraying. -
Wheel-washing
was installed in site -
Well
maintain and check the PMEs |
1.4
Summary
of EM&A Requirements
The detailed EM&A monitoring work
for air quality and noise are
described in Sections 2 and 3 respectively. Regular environmental site
audits
for air quality, noise, water quality and waste management were carried out.
The
following environmental audits are summarized in Section 4 of this report:
·
Environmental
monitoring results;
·
Waste
Management Records;
·
Weekly
site audit results;
·
The status
of environmental licensing and permits for the Project;
·
The
implementation status of environmental protection and pollution control/ mitigation
measures.
Future key issues will be reported in
Section 5 of this report.
1-hour and 24-hour TSP monitoring at
agreed frequencies were conducted to monitor air quality.
The impact monitoring data were checked against the
Action/Limit Levels
as determined in the Baseline Monitoring Report (Construction Phase). Appendix B
shows the established Action/Limit Levels for Air Quality.
Three
dust monitoring locations were selected for 1-hour TSP sampling (AM1, AM2 &
AM3) while four monitoring locations were selected for 24-hour TSP sampling
(AM1, AM2, AM3 and AM4). Table
2.1 tabulates the monitoring stations.

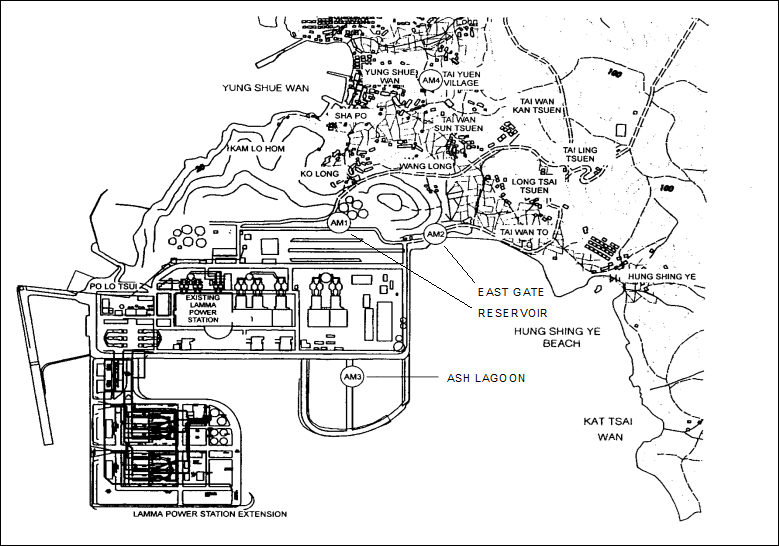

The locations of the monitoring stations are shown in Figure
2.1.
Table 2.1 Air Quality Monitoring Locations
Location I.D. |
Description |
AM1 |
Reservoir |
AM2 |
East Gate |
AM3 |
Ash Lagoon |
AM4 |
Tai Yuen Village |
It
is agreed with EPD that continuous 24-hour TSP air quality monitoring would be
performed using TEOM continuous dust monitor and the MINIVOL Portable Sampler
at AM1,2&3 and AM4 respectively.
TEOM continuous dust monitors were used to carry out 1-hour TSP
monitoring at AM1, AM2 and AM3. Table 2.2 summarises the equipment used in dust monitoring.
Table
2.2 Air Quality Monitoring Equipment
Equipment |
Model and Make |
24-hour
sampling: Continuous
TSP Dust Meter MINIVOL
Portable Sampler 1-hour
sampling: Continuous
TSP Dust Meter |
TEOM continuous dust monitor Thermo Scientific AIRMETRICS TEOM continuous dust monitor Thermo Scientific |
2.4
Monitoring Parameters, Frequency and Duration
Table 2.3 summarises the monitoring parameters, duration and
frequency of air quality monitoring. The
monitoring schedule for the reporting month is shown in Appendix
C.
Table 2.3 Air Quality Monitoring Parameter, Duration and Frequency
Monitoring Stations |
Parameter |
Duration |
Frequency |
AM1 |
1-hour TSP |
1 |
3 hourly samples every 6
days |
24-hour TSP |
24 |
Once every 6 days |
|
AM2 |
1-hour TSP |
1 |
3 hourly samples every 6
days |
24-hour TSP |
24 |
Once every 6 days |
|
AM3 |
1-hour TSP |
1 |
3 hourly samples every 6
days |
24-hour TSP |
24 |
Once every 6 days |
|
AM4 |
24-hour TSP |
24 |
Once every 6 days |
2.5
Monitoring Procedures and Calibration Details
MINIVOL (24- hour TSP Monitoring):
Preparation
of Filter Papers
·
Visual
inspection of filter papers was carried out to ensure that there were no
pinholes, tears and creases;
·
The
filter papers were then labeled before sampling.
·
The filter
papers were equilibrated at room temperature and relative humidity < 50% for
at least 24 hours before weighing.
Field Monitoring
·
During
collection of the sampled filter paper, the information on the elapse timer was
logged. Site observations around the
monitoring stations, which might have affected the monitoring results, were
also recorded. Major pollution sources,
if any, would be identified and reported.
·
The post-sampling
filter papers were removed carefully from the filter holder and folded to avoid
loss of fibres or dust particles from the filter papers;
·
The
filter holder and its surrounding were cleaned;
·
A pre-weighed
blank filter paper for the next sampling was put in place and aligned
carefully. The filter holder was then
tightened firmly to avoid leakage;
·
The
programmable timer was set for the next 24 hrs sampling period;
·
The
post-sampling filter papers were equilibrated at room temperature and relative
humidity < 50% for at least 24 hours before weighing.
TEOM continuous dust monitor
(24- hour TSP and 1- hour TSP Monitoring):
·
The
following parameters of the TEOM model dust meters are regularly checked to
ensure proper functionality:
o
Operation
Mode;
o
Frequency
of the tapered element;
o
Main flow;
o
Bypass
flow.
Maintenance
& Calibration
·
The monitoring
equipment and their accessories are maintained in good working conditions.
·
Monitoring
equipment is calibrated at monthly intervals.
Calibration details are shown in Appendix F.
All
dust monitoring works were conducted on schedule. All monitoring data and graphical
presentation of the monitoring results are provided in Appendix
D. Key findings and observations are
provided below:
1-hour
TSP
No
exceedance of 1-hour TSP Action/Limit Level was recorded in the month.
24-hour
TSP
No exceedance of 24-hour TSP Action/Limit Level was recorded
in the month.
3.
NOISE
Continuous
noise alarm monitoring at Ash Lagoon/Ching Lam were carried out to calculate the noise contributed by the construction
activities at the two critical NSR’s, viz. Long Tsai Tsuen/Hung Shing Ye
and the school within the village of Tai Wan San Tsuen. The impact monitoring data for construction
noise were checked against the limit
levels specified in the EM&A Manual. With the availability of the construction
noise permits, impact monitoring for the construction work during the
restricted hours was also carried out.
Section 3 presents the details of the construction noise permits.
The impact noise monitoring data were checked against the limit levels specified in the EM&A
Manual. Appendix B shows the
established Action/Limit Levels for noise.
In accordance
with the EM&A manual, the identified noise monitoring locations of Ash

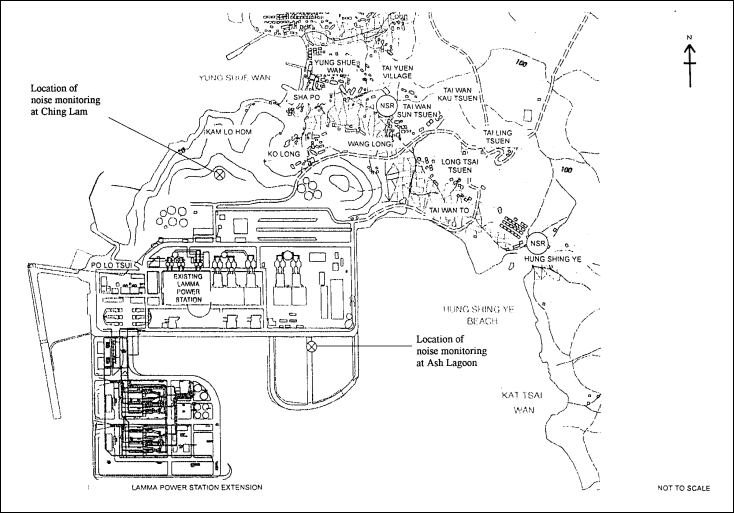

Lagoon and Ching Lam are shown in Figure 3.1.
The sound
level meters used for noise monitoring complied with International
Electrotechnical Commission Publications 651:1979 (Type 1) and 804:1985 (Type
1). The noise monitoring equipment used
is shown in Table 3.1.
Table 3.1 Noise Monitoring Equipment
Equipment |
Model |
Sound level meters |
B&K 2250 |
Sound level calibrator |
B&K 4231 |
3.4
Monitoring
Parameters, Frequency and Duration
Continuous
alarm monitoring was carried out at Ash Lagoon and Ching Lam. The measurement
duration and parameter of noise monitoring were presented in Table 3.2 as follows:
Table 3.2 Noise Monitoring Duration and Parameter
Location |
Time Period |
Frequency |
Parameter |
Ash Lagoon Ching Lam |
Day-time: 0700-1900 hrs on normal weekdays Evening-time & holidays: 0700-2300 hrs on holidays; and 1900-2300 hrs
on all other days Night-time: 2300-0700 hrs of next day |
Day-time: 30 minutes Evening-time & holidays: 5 minutes Night-time: 5 minutes |
30-min LAeq 5-min LAeq 5-min LAeq |
3.5
Monitoring
Procedures and Calibration
Details
Monitoring
Procedures
Continuous
Noise Monitoring for Lamma Extension Construction
The
measured noise levels (MNL's) were collected at the
noise alarm monitoring stations at Ash Lagoon and Ching Lam. The notional background noise levels (viz. baseline noise
data at Ash Lagoon and Ching Lam) were applied to correct the corresponding MNL's in 30-min/5-min LAeq.
A wind speed
sensor was installed at Station Building Rooftop. The wind speed signal was used to determine whether the data from Ash
Lagoon and Ching Lam noise alarm monitoring stations were affected. The instantaneous data was
discarded in case the
instantaneous wind speed exceeded 10 m/s. The 30-min/5-min LAeq was considered valid only if the amount of
valid data was equal to or above
70%.
Equipment
Calibration
The sound
level meters and calibrators were verified by the manufacturer or accredited
laboratory. With the endorsement of the
Independent Environmental Checker, the enhancement of calibration of sound
level meter at the noise monitoring stations was implemented. The monthly manual on-site calibration using
sound level calibrator was replaced by the daily auto charge injection
calibration function of the sound level meter.
For additional quality assurance, manual on-site calibration would still
be conducted for the noise monitoring stations once every 6 months. The manual on-site calibrations for Ash
Lagoon and Ching Lam noise monitoring stations were carried out in February
2025 and June 2025. The next
calibrations for the two corresponding noise monitoring stations were scheduled
in August 2025 and December 2025.
Continuous noise
monitoring was conducted at the two monitoring stations at Ash Lagoon and Ching
Lam.
All monitoring
results and their graphical presentations are provided in
Appendix E. No
exceedance of noise Action/Limit Level was recorded in the month.
4.1
Review
of Environmental Monitoring Procedures
The environmental
monitoring procedures
were regularly reviewed by
the Environmental Team. No modification to the existing
monitoring procedures was recommended.
4.2
Assessment of Environmental Monitoring Results
Monitoring results for
Air Quality and Noise
The
environmental monitoring results for Air Quality and Noise in the reporting
month presented in Sections 2 and 3 respectively are summarized in Table 4.1.
Table 4.1 Summary of AL Level
Exceedances on Monitoring Parameters
Item |
Parameter
Monitored |
Monitoring
Period |
No. of Exceedances In |
Event/Action
Plan Implementation Status and Results |
||
Action Level |
Limit Level |
|||||
Air |
||||||
1 |
Ambient TSP (24-hour) |
01/07/2025- 31/07/2025 |
0 |
0 |
|
|
2 |
Ambient TSP (1-hour) |
01/07/2025- 31/07/2025 |
0 |
0 |
|
|
Noise |
||||||
1 |
Noise level at the critical NSR’s predicted by the noise alarm monitoring system |
01/07/2025- 31/07/2025 |
0 |
0 |
|
|
Wastes
generated from this Project include inert construction and demolition (C&D)
materials and non-inert C&D materials.
Inert C&D materials comprise excavated materials and broken concrete.
Non-inert C&D materials comprise general refuse, metals and paper/ cardboard
packaging, plastics, chemical waste, etc.
Inert C&D
material and non-inert C&D material disposed of in July 2025 are shown in Table 4.2.
Table 4.2 Estimated Amounts of Waste in July
2025
Total Inert C&D Waste Materials |
Non-inert C&D Materials |
||
C&D Materials Recycled |
C&D Waste Disposed of at Landfill |
Chemical Waste |
|
0 Tonnes |
3.49 Tonnes |
0 Tonnes |
0 Tonnes |
The monthly waste flow tables prepared by the
contractors are attached in Appendix K
Independent Environmental Checker (IEC) conducted a site inspection on 24/7/2025. The site conditions were generally
satisfactory.
Site
audits were carried out by ET on a weekly basis to monitor
environmental issues at the construction sites to ensure that all mitigation
measures were implemented timely and properly. The site audit findings for the reporting
month are summarized in Appendix H. The site conditions
were generally satisfactory. All
required mitigation measures were implemented.
4.5
Status
of Environmental Licensing and Permitting
All
permits/licenses obtained for the project are summarised in Table 4.3.
Table
4.3 Summary
of Environmental Licensing and Permit Status
Description |
Permit No. |
Valid Period |
Highlights |
Status |
|
From |
To |
||||
Varied Environmental
Permit |
EP-071/2000/D |
28/09/20 |
- |
The whole construction
work site |
Valid |
Construction Noise Permit |
GW-RS0498-25 |
19/05/25 |
18/11/25 |
Civil and building works for Unit L13. Operation of PME during restricted
hours. |
Valid |
WPCO Discharge Licence |
WT00046647-2025 |
18/07/25 |
31/07/30 |
Civil and building works for Unit L13. |
Valid |
Waste Disposal Billing Account |
Account No.: 7054247 |
03/04/25 |
- |
Civil and building works for Unit L13 |
Valid |
4.6
Implementation
Status of Environmental Mitigation Measures
Mitigation measures
detailed in the permits and the EM&A Manual (Construction Phase) are required to be implemented. An updated summary of the Environmental Mitigation
Implementation Schedule (EMIS)
is presented in Appendix I.
4.7
Implementation
Status of Event/Action Plans
The Event/Action
Plans extracted from the EM&A Manual (Construction Phase) are presented in Appendix G.
4.8
Implementation
Status of Environmental Complaint Handling Procedures
In July 2025, no
complaint in relation to the environmental impact of the construction
activities was received.
Table 4.4 Environmental Complaints Received in July
2025
Case Reference / Date, Time Received / Date, Time Concerned |
Descriptions / Actions Taken |
Conclusion / Status |
Nil |
N/A |
N/A |
Table 4.5 Outstanding
Environmental Complaints Carried Over
Case Reference / Date, Time Received / Date, Time Concerned |
Descriptions / Actions Taken |
Conclusion / Status |
Nil |
N/A |
N/A |
5.1
Key
Issues for the Coming Month
Key issues to be
considered in the coming month include:
Unit L13 Civil and Building Works
Noise Impact
·
To
continue monitoring the noise level during construction and to ensure
compliance with the CNP’s already obtained.
Air Impact
·
To
monitor and review the sufficiency of the dust suppression measures provided
and increase the resources accordingly if necessary.
Water
Impact
·
To
treat wastewater in sedimentation tank for reuse on construction activities and
to ensure compliance with the WPCO discharge licence
already obtained.
5.2
Monitoring
Schedules for the Next 3 Months
The tentative environmental monitoring schedules for the
next 3 months are shown in Appendix C.
5.3
Construction
Program for the Next 3 Months
The tentative
construction programs for the next 3 months are shown in Appendix
JAppendix
J.
All monitoring work at designated
stations was performed as scheduled satisfactorily. The environmental monitoring works and site
inspection were performed as scheduled in the
reporting month. All
monitoring results were checked and reviewed.
No Action/Limit level exceedance on 1-hour and 24-hour TSP level was recorded in the reporting month.
No Action/Limit level exceedance on noise was recorded in the reporting month.
Environmental mitigation measures recommended in the EM&A manual
for the construction activities were implemented in the reporting month. No complaint in relation to the environmental impact of the construction activities
was received in the reporting month. No
prosecution was received for this Project in the reporting period.
The environmental performance of the Project
was generally satisfactory.
